Making a Strong Case for Layout

On this major hospital expansion, a robotic solution makes the difference.

Hero Image

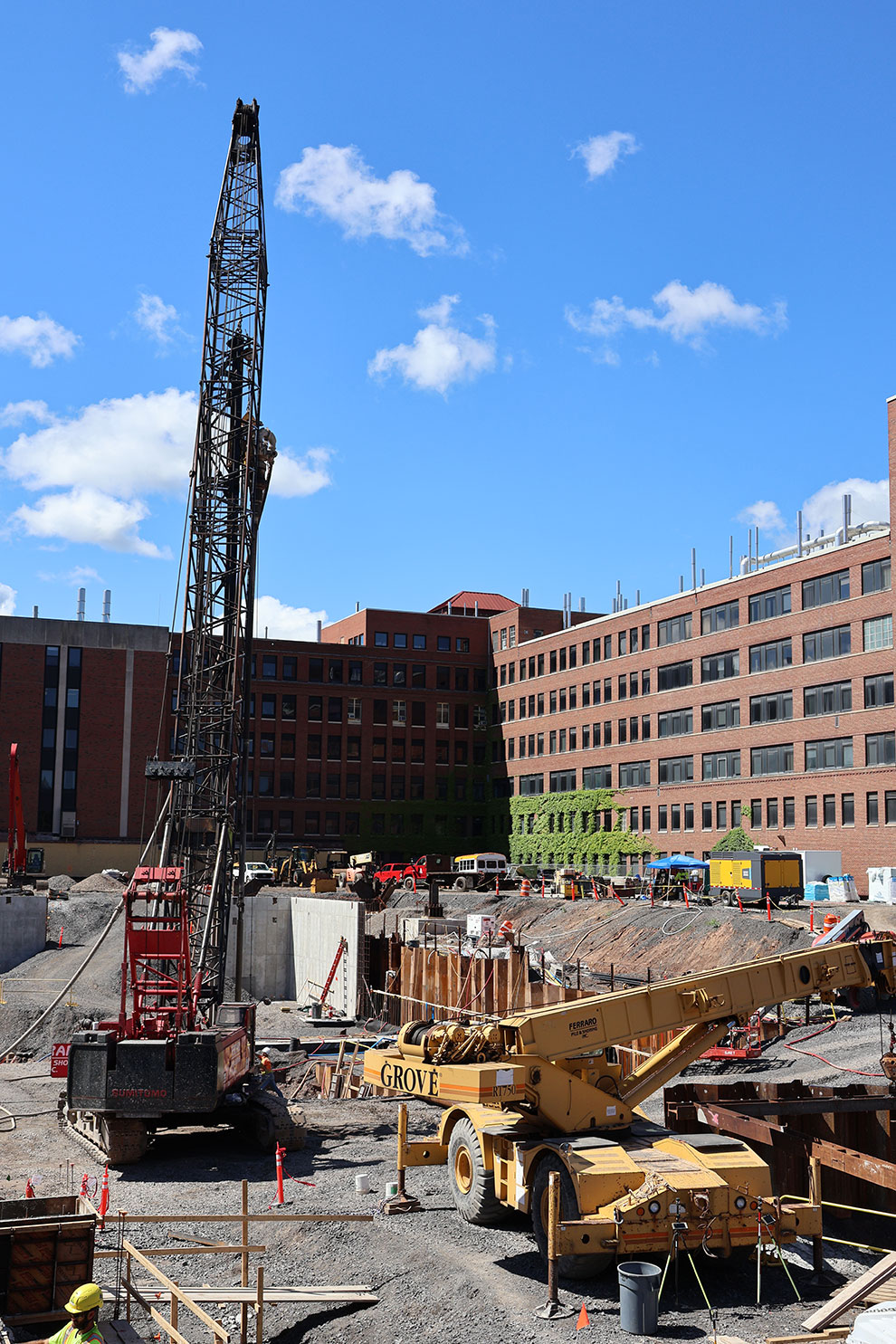

Manning Squires Henning (MSH) is no stranger to larger projects. The Rochester, New York general contractor’s list of notable work includes the Buffalo Bills training facility, several Rochester-area hospitals, and the Strong National Museum of Play, to name just a few. A current project, the expansion of Strong Memorial Hospital, one of the area’s leading medical centers, is formidable in size, adding more than 650,000 square feet of new hospital space to an existing, still-functioning, major health facility. According to Jay Stanley, MSH supervisor, the Strong Tower Expansion, as the project is known, will call all of the company’s strengths into play.

“We are installing pile caps and grade beams for foundations for the main basement of the new structure,” he said. “We are then installing concrete walls up to the ground level elevation, and will do all of the structural, flatwork, slab on grade, as well as all the structural slab-on-deck pours for the nine-story towers. Later, we will be installing the brick and precast facade around the building. It’s the full gamut of work for us — subbing to a joint venture of Turner Construction and Pike Constructions Service — but it’s also what we do best.”

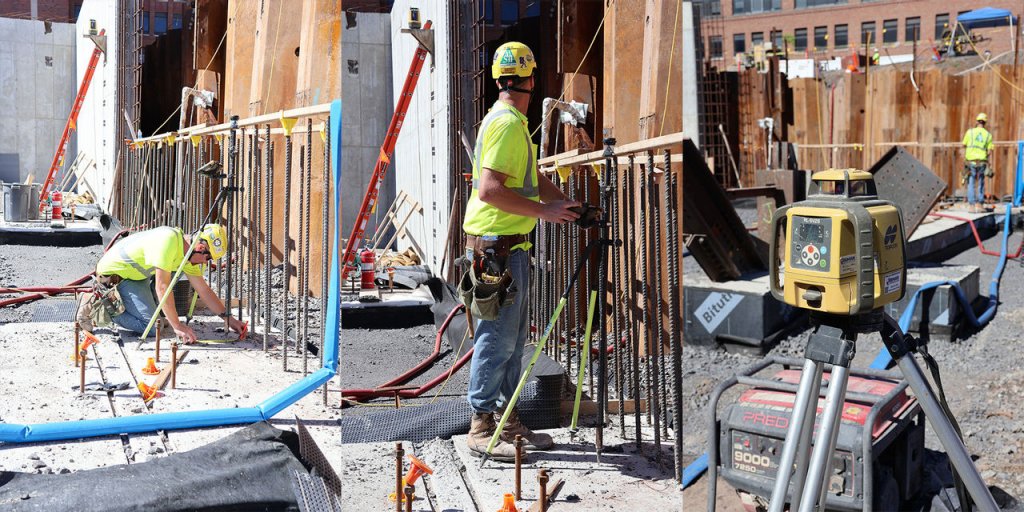

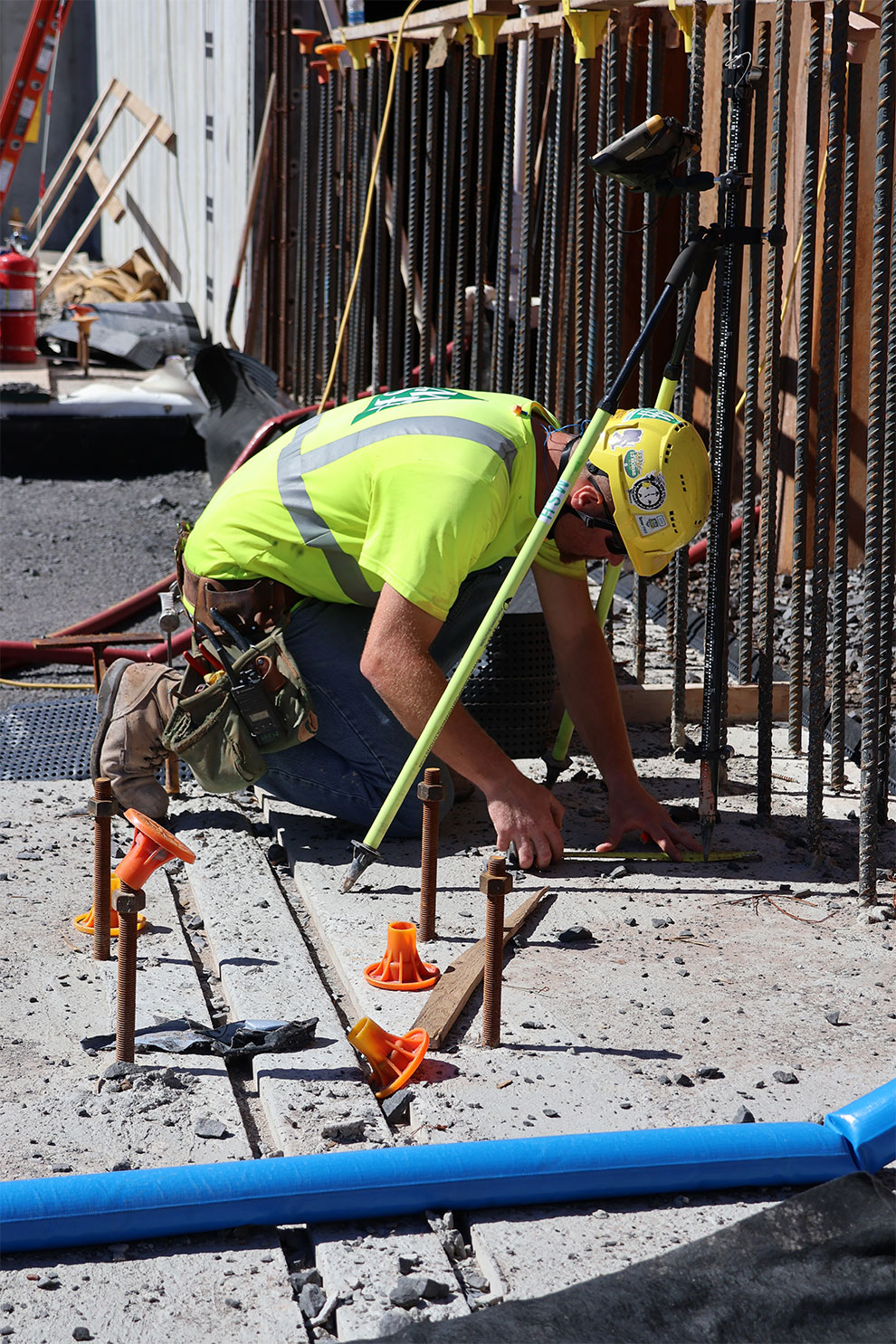

From MSH’s perspective, literally every facet of the Strong Tower project will involve accurate, timely layout. A while back, when a plumb bob, stringline, tape measure and a theodolite were the tools de jour, that might have presented a problem. Fortunately for them, that’s no longer the case.

What’s Out There

Every company, no matter how seasoned, will eventually look at a facet of their workflow and say, “there has to be a better way.” MSH was no exception, seeing its layout effort as slow, labor-intensive and in need of an upgrade. Finding that “better way” was as simple as acknowledging the need to change. According to Stanley, that started by seeing what was happening around them.



“We had seen other companies — including some on the mechanical/electrical/plumbing (MEP) side — utilize robotic instruments at the time,” he said. “Speaking to them and hearing about how dramatically it changed their approach to layout, nudged us in that direction. At the time, we were dealing with a specific manufacturer for a lot of our other tools, so we had them do a presentation for us to see what layout instruments they could provide. After deciding that theirs was too complicated for our needs, we started looking around for something better suited to our needs.”

Reaching Out

That search started with a call on Admar Supply, the local Topcon dealer that provided all MSH’s digital theodolites, instrument calibrations, etc. Quickly understanding MSH’s situation and needs, they gave them a demonstration of the Topcon Layout Navigator, a unique 3D laser robotic layout solution they felt was the ideal fit for them.

“The benefits were obvious right from the get-go,” said Stanley. “The unit’s simplicity was a huge selling point, as was the fact that one person can operate it. Layout isn’t always a team effort; being able to have a guy do that alone is a huge plus. That pretty much sold us on it.”

Designed for simple setup and operation, the Layout Navigator to which Stanley refers, the Topcon LN-150, automatically locks onto a pole-mounted prism/data collector, providing MSH with precise 3D positioning at up to a 130m working radius. Additional benefits the LN provide include a seamless, cloud-connected, workflow with Autodesk, Bentley, and MAGNET software, as well as options for Wi-Fi and long-range Bluetooth communication.

“The benefits were obvious right from the get-go. The unit’s simplicity was a huge selling point, as was the fact that one person can operate it. Layout isn’t always a team effort; being able to have a guy do that alone is a huge plus. That pretty much sold us on it.”

— Jay Stanley, MSH supervisor

The Better to See You

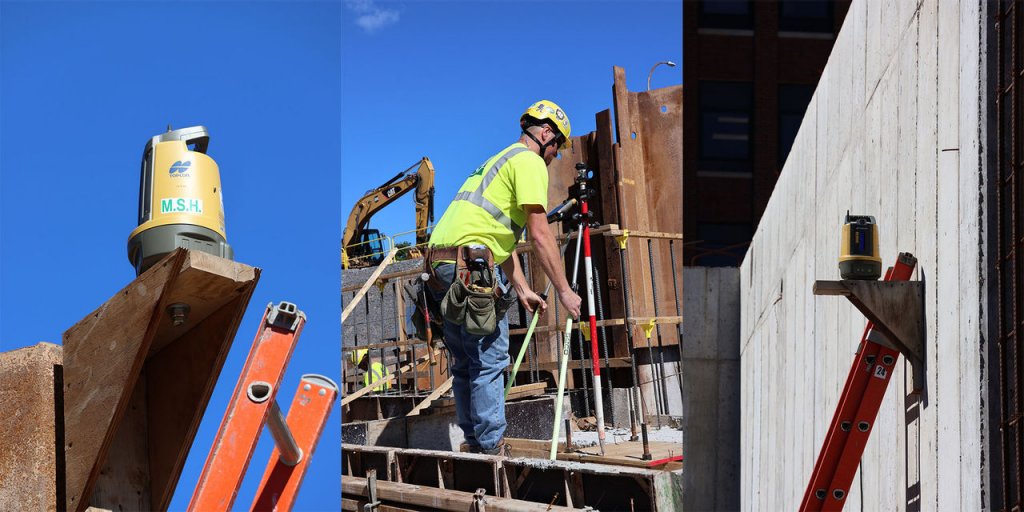

While the Layout Navigator is designed to be tri-pod mounted and portable, MSH has a pair of them semi-permanently attached to brackets embedded in grade beams at the Strong site. Doing so, said Stanley, not only allows for more repeatable, accurate set ups, it also alleviates blockage from the steady stream of trucks into and out of the project, the regular movement of cranes, etc. “The one real challenge out here is that it is an extremely tight area with a large number of trades working at once,” he said. “Because we need to have line of sight to the prism, getting the LNs in a permanent position above most of it helps ensure an uninterrupted connection —  and keeps them intact.”

In addition to the Layout Navigator itself, Stanley said the accompanying Topcon field computers — both FC-5000 and FC-6000 models — are critical tools for maintaining productivity well beyond layout.

“Although they are excellent for all our layout needs, we like the fact that we can use the data collectors for more than just that,” he said. “Because it holds all the information for the job, if one of my team has a quick question about a dimension or a certain location of job, they can instantly bring up that info without having to run back to the trailer for it. Everything about the LN points to savings. It is easily two- to three-times faster than anything we’ve done before, and we get that same two- to three-times improvement in accuracy, reducing the need for do-overs. Simply put: all of that is savings.”

Sharing the Wealth

Perhaps under the heading of “paying it forward,” just as MSH benefited from seeing others using an alternative layout solution, they too were sought out by another company after seeing their level of satisfaction with the LNs.

“At one of our projects, a subcontractor that works with us quite regularly, Frederico Construction, saw how quickly and accurately we were laying out foundation anchor bolts and started asking how we did it,” said Stanley. “We told them about the LN-150 and not long afterward, they had one of their own. Today, they are using it for layout and other survey-based functions as well as part of a 3D control solution for a mini excavator — and pleased with it all. I’d say they did okay asking us about it.”

Stanley will be the first to admit that, though they are very comfortable with the new technology, they are far from savvy users and more than open to new ideas. One such idea came courtesy of the same organization that initially got them into the LN-150: Admar Supply.

“The Admar sales rep recently helped us learn how to set up and access ‘MyTopcon,’ the company’s online support site,” he said. “There are a ton of things that we will find helpful there, but we focused on streamlining how we handle data files. For example, we used to deal with the hassle — and risk — of putting files onto a thumb drive and then downloading them through that same thumb drive. Now, when I receive an e-mail with a CAD file on it, I can load it into ‘MyTopcon’ and no matter where I’m at, I can use a data collector, connect to Wi-Fi or a hotspot, and instantly download the job. The takeaway here is that Admar doesn’t consider its job done after selling us a piece of equipment — they’re always looking for ways to make us better and we like that.”

“The one real challenge out here is that it is an extremely tight area with a large number of trades working at once. Because we need to have line of sight to the prism, getting the LNs in a permanent position above most of it helps ensure an uninterrupted connection — and keeps them intact.”

— Jay Stanley, MSH supervisor

A Numbers Game

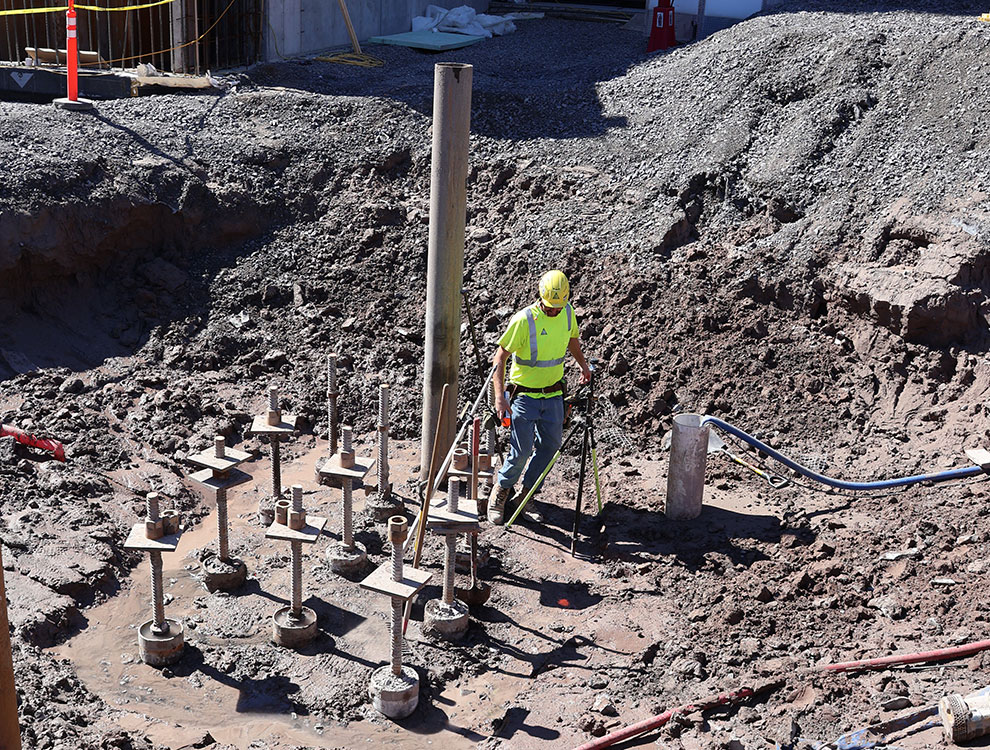

Ease of use and smoothened workflow notwithstanding, next to safety, any contractor’s main consideration will always be accuracy and MSH flies that flag like none other. Almost everything MSH does at the Strong Tower project is subject to pre-set tolerances and specifications. That includes items like the location of a footer, a wall, anchor bolts — even steel embeds that are mounted in the face of a wall for future steel ties.

“The next trade that comes in to set the steel on a bolt or weld steel to the embed plates will as-built those areas prior to beginning work to make sure that our placement is correct for them to install their components,” said Stanley. “We are constantly being checked on every facet of the job and that’s fine. Of course, we always have the utmost confidence in our work — we are even more so now.”

He added that, for the first time since they began working with the Topcon solutions, they are considering having a CAD file built for every floor of the towers as they rise. “There are so many embeds and recesses in this building, floor to floor, that this is a perfect application for the robotic solution,” he said. “Typically we would pull tape and string line off column lines, which would time consuming and a potential tripping hazard. Once we have a file built for every floor, we'll be able to simply lay out what we want, when we want. Using the LNs, it will be a luxury we’ve never had.”

Yet another “better way” to do it.

MSH will wrap up their facet of the project in early 2028 with a grand opening of the new expansion set for later that year.
